How to complete Queensland Form 71 fire hydrant and sprinkler commissioning records in Tradie Forms.

Form 71 records commissioning of fire hydrant and sprinkler systems under Queensland Development Code MP 6.1. You fill it when a new water-based fire safety installation, or an extension to an existing one, is brought into service, then give a copy to the building owner. The official PDF collects hydrostatic, flow, booster, equipment, compliance, and licensee sign-off for the systems you actually commissioned.

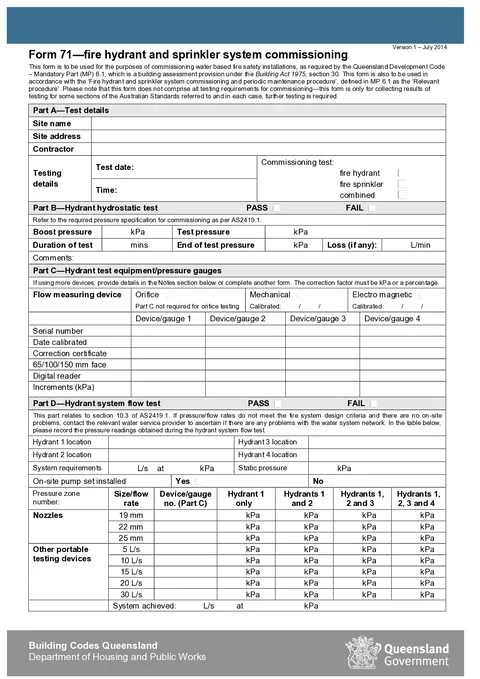

This is the current Queensland Form 71. Tradie Forms follows the official section order and maps your answers onto the official PDF layout.
Form 71 is hardest to reconstruct after you leave site. Gather the readings and identity details while the gauges, test points, and block plan are still in front of you.
Site identity and contractor
Site name, site address, and the contractor or company name that will appear on the owner copy.
Which systems this visit commissioned
Fire hydrant, fire sprinkler, or combined. Only tick systems that were part of this commissioning run.
Hydrostatic and flow readings
Boost, test, end pressures, duration, loss, hydrant locations, system requirements, and achieved results from the instruments on site.
Pump booster figures when a booster was tested
Highest hydrant height, inlet and discharge pressures, boost pressure, and calculated frictional loss.
Equipment identity and calibration
Flow measuring device type, gauge serial numbers, calibration dates, correction certificates, face size, and increments.
Sprinkler test points and block plan notes
System specification, each test location with required and actual flow and pressure, and any running-test gauge pressure.
Compliance decisions and licensee details
Critical defects, repairs or corrective actions, overall system outcome, licensee name, licence number, report number, and signature.
Fill only the hydrant, sprinkler, or combined sections that match this commissioning visit. Leaving an untested section blank is correct; marking it Pass is not.
Identifies the site, who carried out the work, when the commissioning test ran, and which systems the record covers.
The building or project name the owner will recognise on the file, for example Harbour View Apartments. Prefer the name on the block plan or job sheet over a marketing name that will not match later maintenance records.
Site street line. Address search is limited to Queensland and fills the street line, suburb, state, and postcode. Check the result against the job sheet, because search returns the current postal address and a site can predate a street rename or subdivision.
Defaults to QLD if left alone. Confirm it when typing the address by hand so the record stays Queensland-scoped.
Filled by address search. Confirm against the job sheet when typing manually.
Trading name of the contractor or company that carried out the commissioning, for example Coastal Fire Protection Pty Ltd. This is what the owner sees as the service provider on the finished PDF.
Date the commissioning tests were done. Today and Yesterday shortcuts are available. Future dates are not accepted, so you cannot date the record ahead of the tests.
Time the test run started or was recorded on site, for example 09:30. Take it from the site notes rather than guessing later in the office.
Commissioning Test is the fire hydrant, fire sprinkler, and combined matrix. Tick only the systems actually commissioned on this visit. Combined means the hydrant and sprinkler systems were tested together as one commissioning run, not that you should fill every later section automatically.
Save this section as Contractor to prefill it on your next Form 71 commissioning job for the same company.
Records the hydrant hydrostatic test against the pressure specification in AS2419.1 or AS1851. Complete this section when a hydrant hydrostatic test was part of the commissioning run.
Pass or Fail for the hydrostatic test. Match the instruments and the standard you tested to, not a target you hoped to meet.
Boost pressure in kPa from the test setup, for example 1200. Read it from the gauge used for the test, not from a design schedule alone.
Held test pressure in kPa, for example 1400. This is the pressure the system was taken to for the hold period.
Hold duration in minutes, for example 120. Use the timed hold from the test, not a rounded estimate from memory.
Pressure in kPa at the end of the hold, for example 1395. Needed so any drop is visible next to the start test pressure.
Measured loss in L/min, for example 0 when none was observed. Enter the measured figure rather than leaving a fail outcome unexplained.
Defects, limitations, or follow-up work that the owner should see with the hydrostatic result, for example Hydrostatic test completed with no visible leaks. Leave blank only when the readings stand alone.
Documents the flow measuring device and pressure gauges used for the hydrant tests. If a reading depends on a device, the device has to be identified on the record.
Orifice, Mechanical, or Electro Magnetic. Part C gauge detail is not required for orifice testing. For mechanical or electro magnetic, fill the calibrated date that expands under that option from the device certificate or sticker, not from a previous job.
Add up to four Device/Gauge rows for the gauges used on this test. Each row takes serial number, date calibrated, correction certificate, face size (mm), digital reader yes or no, and increments in kPa. Leave unused rows out rather than adding blanks. If you used more than four devices, note the extras in comments or complete another Form 71, which is what the official form points to.
Records hydrant system flow test results under section 10.3 of AS2419.1. Use hydrant location wording that still makes sense without the block plan open.
Pass or Fail for the hydrant flow test as a whole. Align it with the readings and the system achieved figures, not with a separate verbal summary.
Where hydrant 1 sits on the site, written so an owner or later contractor can find it.
Basement car park NE riser
H1
Location for hydrant 2 in the same plain language as hydrant 1, for example Ground floor loading dock.
Location for hydrant 3 when a third hydrant was used in the flow test, for example Level 3 east stair.
Location for hydrant 4 when a fourth hydrant was used, for example Roof plant room.
System required flow rate in L/s from the design or block plan, for example 20. This is the requirement, not the achieved result.
System required pressure in kPa, for example 200. Take it from the design criteria you tested against.
Static pressure in kPa recorded for the system, for example 450.
Yes or No. Answer from what is installed on this site, because it changes how a reader interprets low network pressure.
Two values: achieved flow rate in L/s and achieved pressure in kPa from the flow test, for example 22 L/s and 210 kPa. Enter what the instruments showed, not the design target again.
The flow reading table records pressure by nozzle size or portable device flow rate against hydrant combinations, with a device or gauge number that points back to Part C. Fill only the rows and hydrant columns you actually tested. If pressure or flow rates do not meet design criteria and there are no on-site faults, the official form points you to contact the relevant water service provider.
Records pump appliance booster test results under sections 10.4 and 10.5 of AS2419.1 when a booster test was part of commissioning.
Pass or Fail for the booster test. Match the inlet, discharge, and boost figures you recorded on site.
The hydrant path used for the booster test, written for someone without the block plan, for example Basement booster to roof hydrant ring.
Height in metres of the highest hydrant above the booster, for example 32. Take it from the design or a measured site figure, not a guess.
Required flow rate in L/s for the booster test, for example 20.
Required pressure in kPa for the booster test, for example 200.
Static pressure in kPa for the booster test setup, for example 450.
Pump inlet pressure in kPa, for example 380. Read from the inlet gauge during the test.
Pump discharge pressure in kPa, for example 1200.
Boost pressure in kPa delivered by the pump set, for example 820.
Calculated frictional loss in kPa, for example 45. Use the calculated figure from the test method you applied.
Limits, defects, or follow-up that belong with the booster result, for example Booster test completed within design criteria.
If pressure or flow rates do not meet design criteria and there are no on-site problems, contact the relevant water service provider, as the form notes.
Records the sprinkler hydrostatic test against AS2118.1, AS2118.4, and AS2118.6 when a sprinkler hydrostatic test was part of commissioning.
Pass or Fail for the sprinkler hydrostatic hold.
Test pressure in kPa, for example 1200. Match the required specification for the AS2118 part that applies to this system.
Hold time in minutes, for example 120.
Pressure drop, repairs, or limitations the owner should see, for example No pressure loss observed during hold period.
Records sprinkler system flow test results for AS2118.1-1999 section 4.14, AS2118.6-2012 section 4, and AS2118.4-2012 section 6.2. Multiple testing points may be required on larger systems. For some AS2118.4 systems without a flow measuring device, a simulated running test may be required.
Short description of the system as shown on the block plan, for example Wet pipe system to AS2118.1. Keep it specific enough that a later reader knows which system was tested.
Overall summary of the sprinkler flow test, for example Test point 1 and 2 within specification. This sits above the individual test point rows on the PDF.
Installation gauge pressure in kPa for a running test, for example 195. Fill when a running or simulated running test was done.
Extra test points, limitations, or follow-up. If more than two locations were tested, list the extras here because the form holds two test point rows.
Add up to two Test Point rows when multiple testing points are required. Each row has test location, required and actual flow (L/min), required and actual pressure (kPa), and pass or fail for flow and pressure. Leave unused rows out. Use location wording that stands without the block plan open.
Declares critical defects, repairs or corrective actions, and the overall system outcome after the commissioning tests that apply to this visit.
Yes or No. If Yes, the form notes that the owner or occupier is given a critical defect notice. Keep that notice with the job file so the PDF is not the only record of the defect.
Yes or No. If Yes, attach action and date details as part of the licensee report. A Yes without supporting detail in the job file is the usual gap owners and later contractors hit.
Overall Pass or Fail for the systems covered by this Form 71. It has to agree with the section outcomes and any critical defects recorded above, not with a separate verbal handover.
Licensee declaration for Form 71. By signing, the licensee confirms the information is correct to the best of their knowledge given the available information, and that the form has been completed in accordance with the relevant standards, codes, and regulations. Sign after the readings and compliance answers match what you are prepared to put on the owner copy.
Name of the appropriately qualified licensee signing the record, for example Jordan Lee. Match the person who takes responsibility for the commissioning record.
Signature of that licensee. Capture it on site when you can. You can use a saved signature. The signature lands on page 2 of the official PDF in the licensee block.
QBCC or PIC licence number as printed on the card, for example QBCC1234567. Licence check can look up the QBCC register and prefill the licensee name; confirm the name still matches the person who is signing.
Your report number for this commissioning job, for example F71-2026-0612. Use a number that ties the PDF back to your internal job file.
Save this section as Licensee to prefill it on your next Form 71 commissioning job for the same licensee.
Using Form 71 for routine maintenance on an existing system.
Form 71 is for commissioning a new system or an extension. Annual and five-year maintenance of a system already in service belongs on Form 72. The job moment decides the form, not how similar the reading tables look.
Treating the finished PDF as the whole commissioning file.
The official form says it does not cover all commissioning testing requirements. Keep test sheets, drawings, block plans, and gauge references with the PDF so the owner copy has a trail behind it.
Leaving gauge serial and calibration details blank.
If a reading depends on a device, identify the device. Missing serial numbers or calibration dates make the record harder to trust when a later contractor or owner opens the file.
Writing hydrant locations as H1 or Stage 2 only.
Codes that only make sense with the block plan open fail as soon as the plan is filed separately. Name the floor, riser, or dock so the location stands alone.
Marking Pass on sections that were not tested.
Tick only the systems commissioned on this visit and complete only those sections. An untested section left blank is honest; a Pass without readings is not.
Recording critical defects or repairs without the supporting notice.
A Yes on critical defects or corrective actions needs the notice, action, date, and any photos in the job file. The PDF alone does not carry that detail.
Signing before the system outcome and report number are checked.
The signature block is the last chance to catch a wrong report number, licence number, or overall pass or fail that does not match the section results.
QDC MP 6.1 says the appropriately qualified person who carries out commissioning completes the relevant form and gives a copy within 10 business days after completing the work. For commissioning, that copy goes to the building owner. MP 6.1 also says the person must keep a record of the form for at least five years.
Form 71 - Harbour View Apartments - 2026-06-01.pdf over a generic contractor-only name when you commission multiple buildings.Check the current Queensland Development Code and Business Queensland requirements for your job. Retention and handover expectations sit with MP 6.1 and the authority's current guidance.
Fuller run through each part of the commissioning record and what to keep with it.
When the job is commissioning versus periodic maintenance, and who receives the copy.
Section help for the periodic testing and maintenance record on an existing system.
The regulator publications this guide is based on. Always check the current official form before you lodge.
